AI data centers are straining the grid faster than utilities can build. Fast storage is filling the gap.
AI data centers require power within months, but grid upgrades take years. To address this gap, fast storage solutions are becoming essential. Additionally, FERC is influencing how utilities manage their power resources.
This story was produced through MarketScale. See how Energy teams put it to work with Customer Stories & Case Studies.
Key facts, context, and what it means, in one minute.
Key takeaways
AI data centers need rapid power supply.
Grid upgrades are slower than the demand from AI centers.
Fast storage solutions are critical in bridging the supply gap.
A single AI data center campus can draw more electricity than a mid-sized city. Sometimes more than an entire state. That load can arrive in months. The grid upgrades needed to serve it reliably take years. That gap is the defining operational problem facing utility planners and energy procurement teams in 2026.
According to Utility Dive, AI data centers, new manufacturing facilities, and the electrification of vehicles and buildings are driving the fastest electricity demand growth in a generation. The interconnection queue, the waiting list for new projects to get a grid connection, has grown so long that customers who have already signed contracts often cannot be served on schedule. Building new capacity is the textbook answer, but the load won't wait for textbook timelines.
A structural mismatch utilities can't build their way out of quickly
The problem runs deeper than just queuing. As aging thermal power plants retire and more generation comes through power electronics rather than large spinning turbines, the grid loses a passive stabilizer. Rotating machine mass has historically acted as a mechanical buffer against sudden frequency swings. With that cushion shrinking, the grid requires faster-responding resources to maintain balance, according to Utility Dive.
Communities feeling the weight of this shift are not just in tech corridors. The Lincoln Journal Star has reported on how large energy-consuming projects are reshaping communities across America, with local infrastructure and utility planning strained by facilities that arrive faster than planners anticipated.
For a VP of operations or an energy procurement director, the immediate question is not whether demand growth is real. It is whether the tools available today can absorb loads that existing infrastructure was not designed to handle.
FERC acts, and the economics of flexibility sharpen
Federal regulators moved on this in June 2026. FERC directed regional grid operators to revisit their rules for connecting large new loads and to formally incorporate customers that can adjust their consumption on request, according to Utility Dive. The directive treats demand flexibility not as a bonus feature but as a planning resource with real grid value.

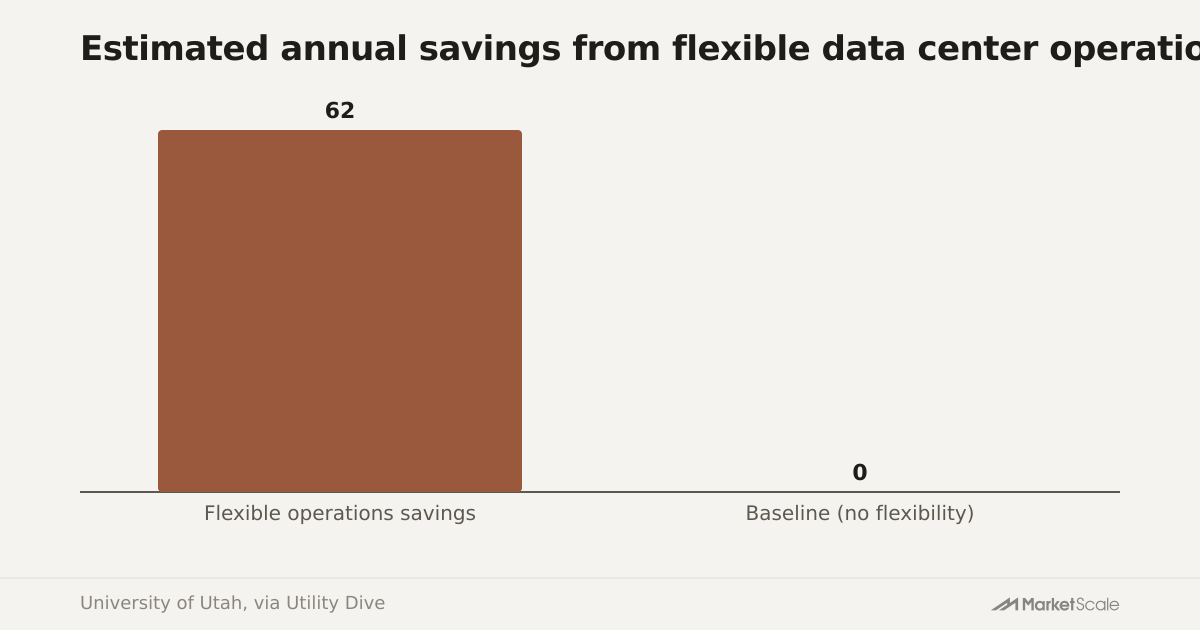

The financial case for that flexibility is now quantified. A University of Utah study modeled the Western grid and found that operating data centers more flexibly, shifting workloads toward off-peak periods, could save the system an estimated $62 million per year in operational costs, according to Utility Dive. For utilities negotiating large-load service agreements, that number gives flexibility provisions a concrete line item in the business case.
Fast storage as the near-term bridge
Nate Walkingshaw, founder and CEO of Torus, argued in Utility Dive that fast-response storage is the practical bridge between the speed at which new loads arrive and the speed at which the grid can formally expand. The premise is that loads capable of flexing up and down on request, backed by co-located storage that can respond in seconds, give utilities a dispatchable buffer without waiting for new transmission approvals.
The FERC directive aligns with that framing. By requiring grid operators to plan around flexible large loads, the agency is effectively signaling that fast storage and demand-management agreements need to be in the utility toolkit today, not after the next rate case.
For procurement and operations teams evaluating large-load service terms this year, the practical question is whether their current contracts include flexibility provisions, and whether the storage or demand-response assets behind those provisions can actually respond at grid speed. FERC's action means that question is no longer advisory.
What this means for your team
- Audit your large-load interconnection agreements for demand-flexibility clauses. FERC's June 2026 directive means regional operators will increasingly require that flexibility to be contractually defined.
- Evaluate whether any co-located or behind-the-meter storage assets can respond fast enough to qualify as a grid resource under revised interconnection rules, not just as backup power.
- Model the operational cost savings from off-peak scheduling for any energy-intensive facilities. The University of Utah's $62 million Western-grid estimate provides a methodology and benchmark to adapt internally.
- Engage your utility account team now about how they are implementing FERC's large-load integration guidance, since timing and rule specifics will vary by regional grid operator.
